Publish on approval

Publish on approval is the only way pages publish without someone clicking Publish. When an approval reaches Approved, the page is queued for publishing with the method Approval, and the people who approved it are shown as Approved by in the Publishing byline.

It needs an app that includes both Approval and Publishing, such as the Capable Suite or Approval for Confluence. The standalone Publishing app has no approvals, so nothing can trigger it there.


#Where to switch it on

Level

Where

What it does

Whole space

Space settings, Approval, Overrides tab, Publish on approval

Publishes every approved page in the space. Overrides team and per-approval settings, and locks the per-approval checkbox on.

Approval team

The team's settings

Publishes pages approved by that team.

One approval

The approval byline options, Publish on approval

Publishes this page when this approval is approved. Only shown when publishing is enabled for the space.

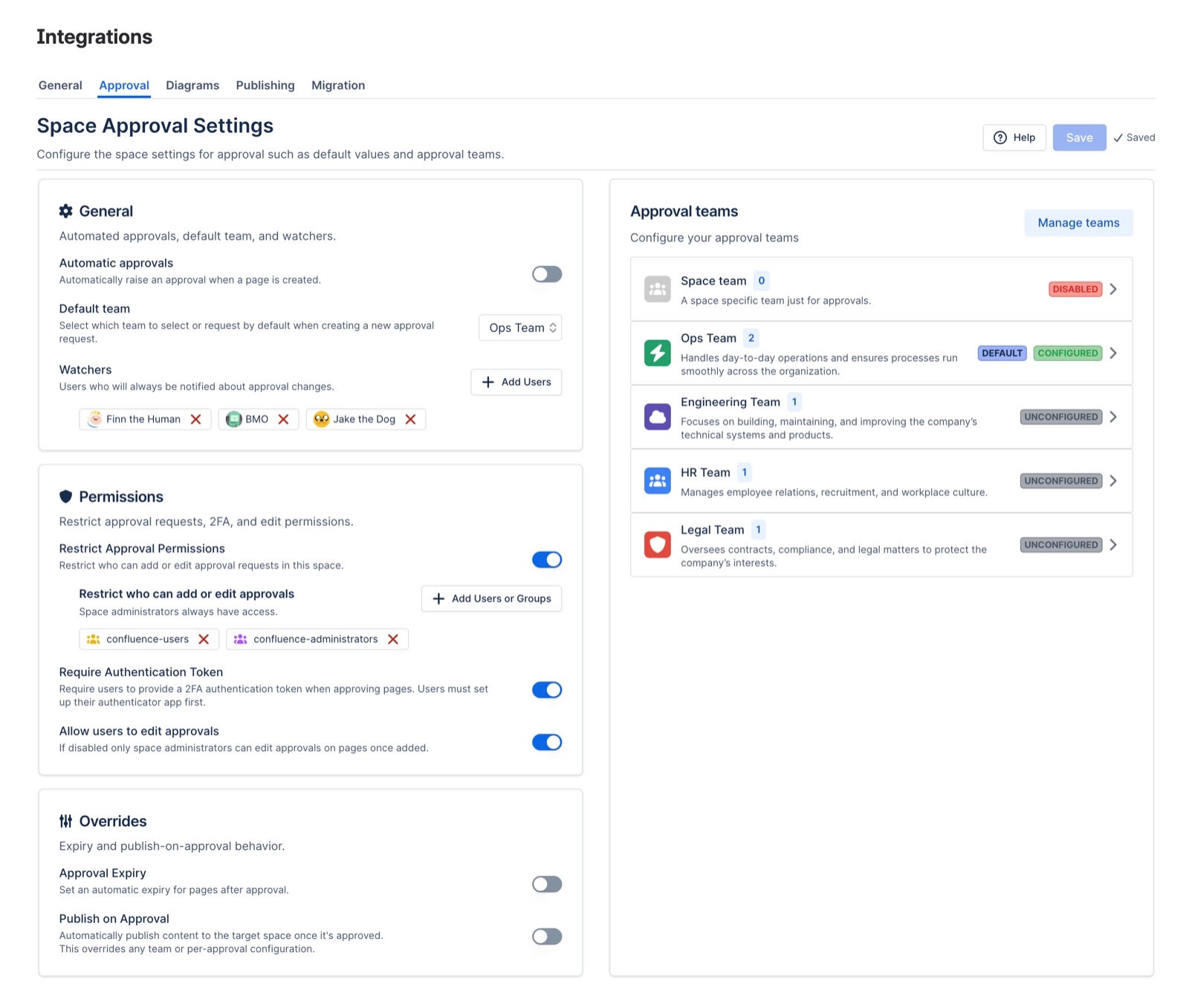

Space Approval Settings with the Overrides tab open, showing Approval expiry set to 1 Month and the Publish on approval switch turned on
On the Overrides tab, switch on Publish on approval. It takes precedence over any team or per-approval setting.

#Before it works

1
Turn on publishing
2
Switch it on
3
Approve

Publishing must be enabled for the space, with a target space chosen, on the Setup tab of Publishing Space settings. See Publishing settings.

✓
Turn on publishing
2
Switch it on
3
Approve

Switch on Publish on approval for the space, the team or the approval, as in the table above.

✓
Turn on publishing
✓
Switch it on
3
Approve

When the approval reaches Approved, the page is queued and published a few moments later. Its byline then shows Published with the tooltip Published via Approval.


#How the page tree is kept

With Preserve hierarchy on the Structure tab, approvals can arrive in any order and the target space still ends up mirroring the source.

Situation

What happens

The parent page is already published

The page goes under its parent's published copy.

The parent is a folder

The folder is created in the target space if it is not there yet, then the page goes inside it.

The parent page is not published yet

The page goes under its nearest published ancestor, or the parent page set on the Structure tab, or the target homepage. When the parent is published later, the page moves under it.

Several pages in one tree are approved at the same time

Each is placed by the same rule, and they settle into the right tree within a few minutes.

Someone moved the published copy by hand in the target space

It is left where it is. Publishing only moves pages that sit where it put them.


#A few things that catch people out

  • The note under Publish on approval on the Overrides tab still asks you to publish parent pages before child pages. Since 19 October 2026 that is no longer needed.

  • Page restrictions are not carried onto the published copy, so a restricted source page becomes an unrestricted page in the target space.

  • Nobody is told when an approval publish fails. Check the Failed list on the Publishing space page.

  • A page with the capable_never_publish label is never published, even when approved.

  • Status lists and counts come from Confluence search, so a page published a moment ago can take a little while to show as Published.



Approved means published.
