What is recorded

When somebody asks you to prove that a document was reviewed and approved, a green tick is not an answer. Capable keeps a permanent record of every approval action on every page, tied to the exact version of the page it applied to.


#What is kept

Every one of these is recorded with the person who did it and the time they did it.

Event

Recorded when

Requested

An approval is raised on the page.

Added

Somebody is added to the approver list.

Approved, Rejected, Commented

Somebody answers.[1]

Removed

The approval is withdrawn.

Expired

An approved page comes back around for review.

Published

Approval triggers a publish. See Publishing.

Each event carries the page version it applied to, so you can always answer which version of this document they actually approved.


#The history is append only

Answers can be changed, but nothing is ever erased. If somebody approves, then changes their mind and rejects, both events stay in the record with their timestamps.


#Signed responses

Where a space requires an authenticator code, responses given with one are marked as authenticated and shown with a padlock. No device or network detail is kept, only that a code was checked. See Sign approvals with a code.


#Capable checks its own records

The approval summary stored on each page carries a fingerprint of its own contents, and Capable verifies it every time the status is displayed.[2] If the stored state no longer matches its fingerprint, or the approval no longer matches the version of the page it was given for, you are told, rather than being shown a status that is not true.

Badge

Meaning

APPROVED

The record is intact and matches this version of the page.

IN REVIEW

Also shown briefly after an edit, while things settle.

CORRUPT

An approved page no longer matches the record. Investigate before relying on it.

REPAIR NEEDED

Usually an approval old enough to predate this checking. Repair it to bring it up to date.


#Getting the evidence out

You need

Use

One page, in full

The approval history on the page. See View approval history.

A whole space or site, as a spreadsheet

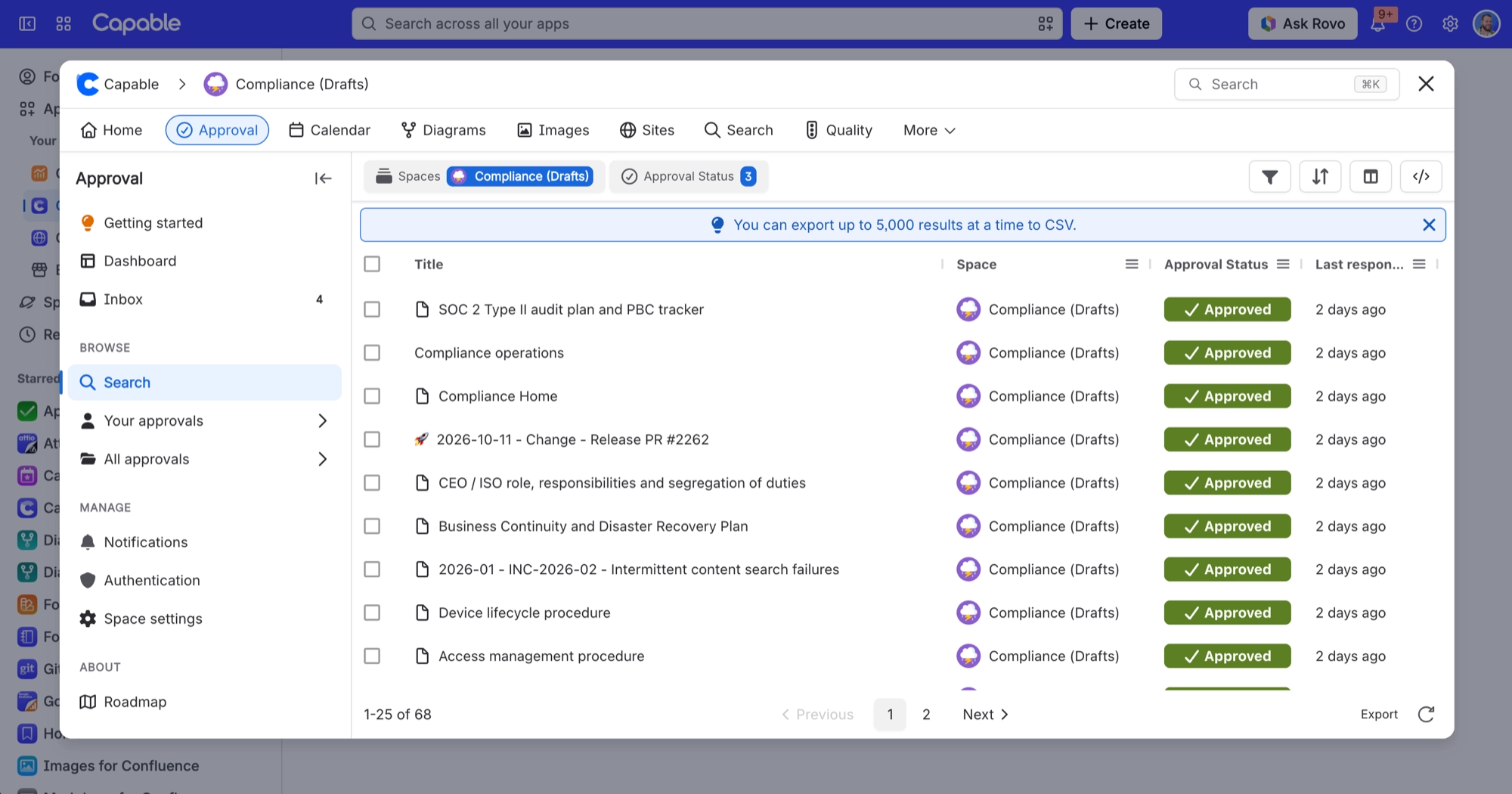

An export from Search and reporting, with the email columns added.

Evidence inside the document itself

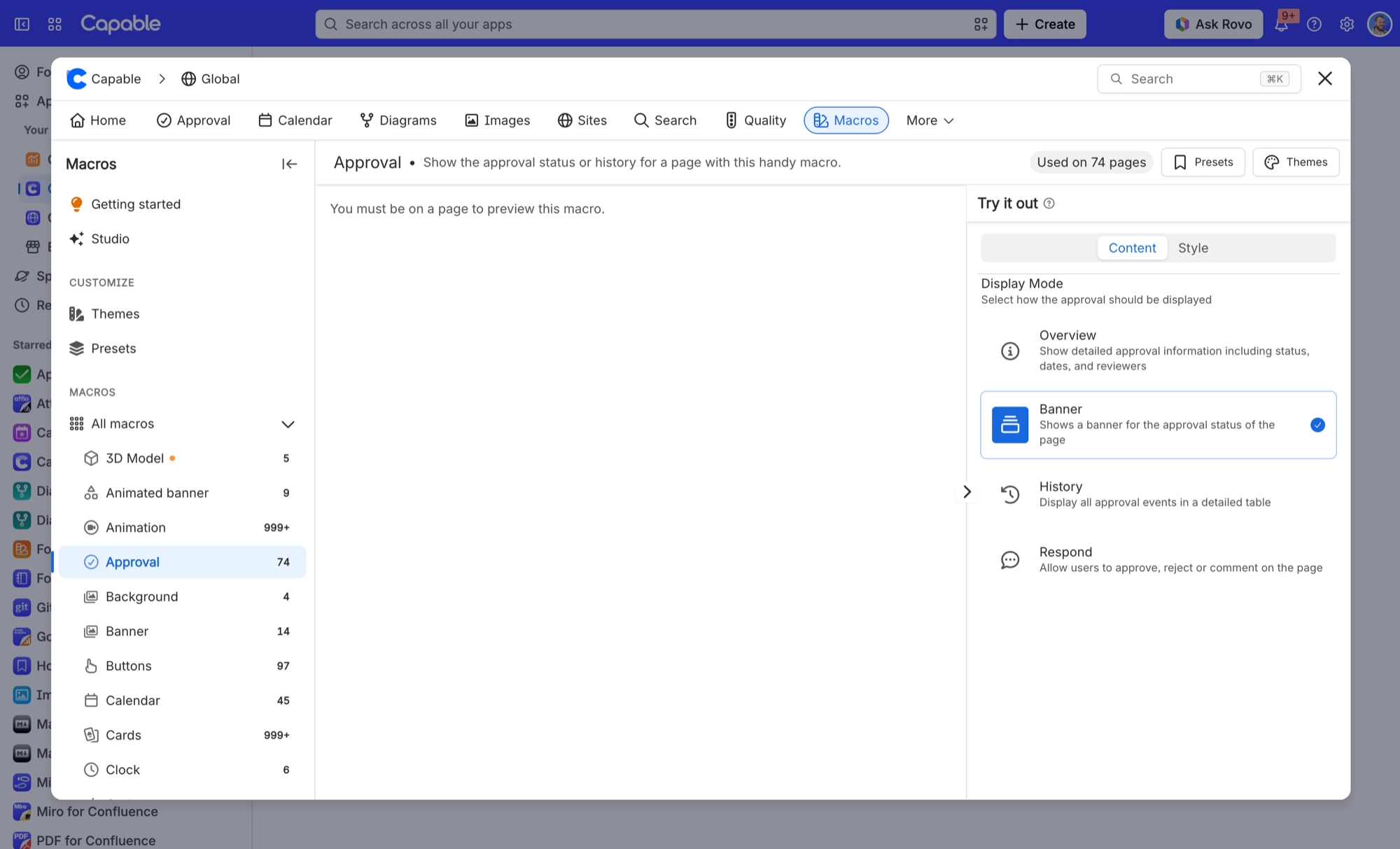

The approval macro in History or Metadata view, which travels into published sites. See The approval macro.


#What is not in this record

Worth knowing before an audit, so nothing is a surprise on the day.

  • Administrative changes are not logged here. Turning the code requirement on or off, changing space settings, resetting an authenticator and editing team membership leave no trace in the approval history.

  • The CSV export does not carry the signed marker. The padlock is visible in Confluence but not in the exported file.

  • No device or network detail is kept against a signed response, only that a code was checked.

  • An approver can change their answer after completion. Both events are kept, but freezing a decision has to be a procedural control. See Compliance.


  1. The note left with an answer is capped at 500 characters. A long rationale belongs on the page itself, where it is versioned and searchable, rather than in the response box.
  2. There is a short grace period after an edit, so a page you have just changed shows In review rather than a warning while the update settles.


Everything an auditor asks for, already written down.
